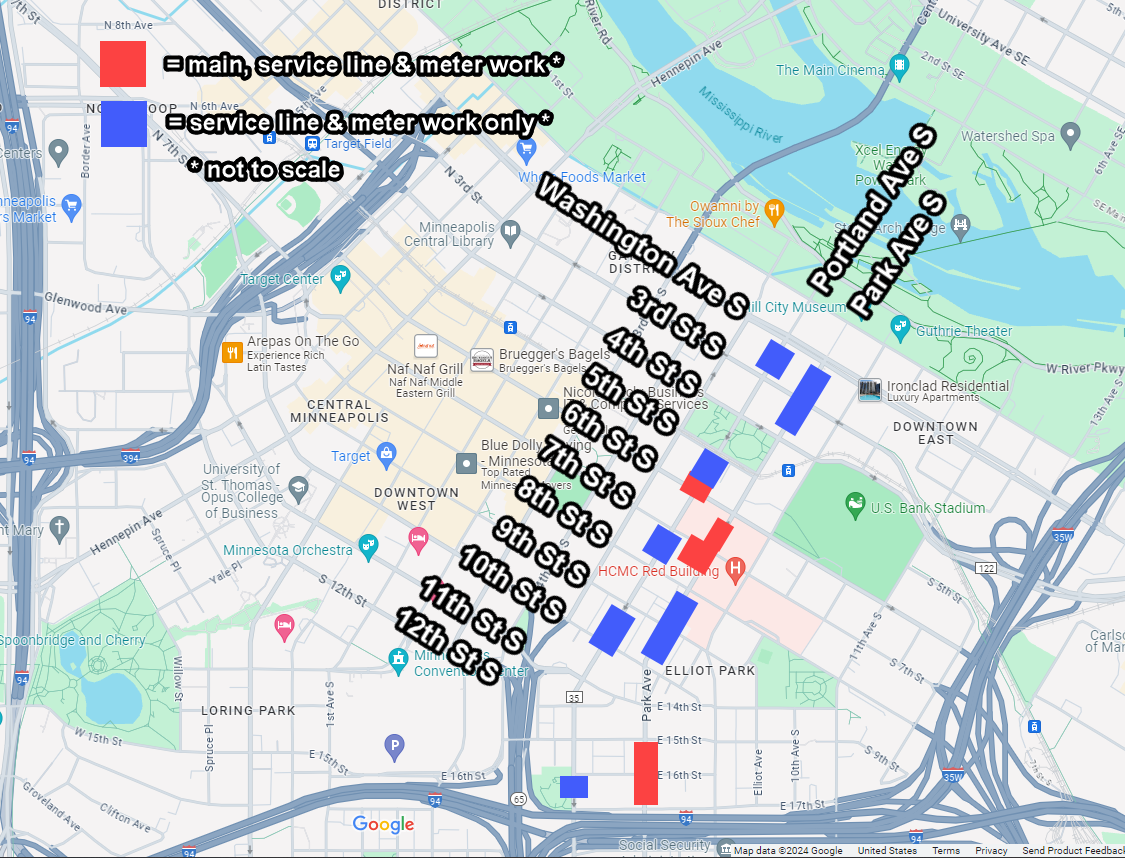

​​​Minneapolis – Downtown East and West


Anticipated timeline: From June into July 2024


CNP Map of Minneapolis Downtown East and West.png


Project resources

  • If you contact CenterPoint Energy, please reference the project’s work order number 110197863.

Over​view

From June into July 2024, CenterPoint Energy’s authorized contractors will replace CenterPoint Energy’s natural gas infrastructure in Downtown East and West in Minneapolis.

Along the following streets, they will replace the natural gas mains, move inside meters outside by appointment, and replace and/or reconnect service lines to the new main:

  • Park Avenue S. from 15th Street E. to 17th Street E. and from 7th Street S. to 620 Park Avenue S.
  • The intersection of Portland Avenue S. and 6th Street S.
  • 7th Street S. from Park Avenue S. to 619 7th Street S.

Along the following streets, the crews will only move inside meters outside by appointment and replace and/or reconnect service lines to the new main:

  • Park Avenue S. from 10th Street S. to 8th Street S. and from 4th Street S. to Washington Avenue S.
  • ​Portland Avenue S. at 16th Street E., from 10th Street S. to 9th Street S., from 7th Street S. to 8th Street S., from 6th Street S. to 5th Street S., and from 3rd Street S. to Washington Avenue S.

Equix Integrity updates our records on the locations of sewer lines in relation to natural gas lines. Michels Corporation will replace the natural gas plastic mains, move inside meters to the outside of homes by appointment, and replace and/or reconnect natural gas service lines. Q3 Contracting will restore the areas affected by Michels Corporation’s work outside the limits of Hennepin County’s Park and Portland Repaving Project. There will be no assessment or cost associated with our work.


Traffic impacts

During the work, the crews will close lanes, the sidewalk on one side of the road at a time, and parking on both sides on the blocks where they’ll work. Please expect the following closures:

  • 17th Street E. from Park Avenue to about 100 feet west toward Portland Avenue: During this time, traffic will remain open on Park Avenue, while traffic can’t cross 17th Street E. in any direction.
  • ​Park Avenue at 16th Street E.: During this time, traffic will remain open on Park Avenue, while traffic on 16th Street E. can’t cross Park Avenue in any direction. Closures will occur about 100 feet west of Park Avenue for a time, and then 100 feet west and 100 feet east of Park Avenue another time.


Marking uti​lities

CenterPoint Energy will contact Gopher State One Call 811 to locate public underground utilities such as water, sewer, and cable. You will see markings such as spray paint and utility flags. They will be color-coordinated to indicate a separate utility.

If you have installed any private lines such as sprinklers or dog fences, we ask that you mark them with whatever material is convenient for you. Examples include spray paint, flags, and wooden sticks used to stir paint. Marking sprinkler heads is sufficient.

If any utility flags are left in residents’ yards after the natural gas work and the restoration work is done, and the crew do not remove the flags, residents can remove the flags and throw them away.


Natural gas main work

The crew plans to bore the main underneath one sidewalk on each road. Please keep in mind that some intersections or some sidewalk panels at intersections may not be permanently restored until after the service line work is done. After all customers’ service lines are transferred to the new main, the crew can connect the new main to the existing intersecting mains and put the new main into service. Then the restoration crew will permanently restore these areas. Until then, customers may see temporary backfill such as dirt or gravel. We thank you for your patience!


Service line and meter wo​rk

The customer will receive a CenterPoint Energy postcard in the mail before the natural gas crews perform the work. The crews will have CenterPoint Energy-authorized photo IDs. After the customer receives the postcard, the technician will arrive at the customer’s house to schedule an appointment that typically meets with the customer’s schedule. If the customer isn’t home when they arrive, they will leave a door tag with their contact information to schedule an appointment with them.

One natural gas crew typically works on about one block per week. They will either fully replace the service line or reconnect it to the new main, depending on the line’s age. For most properties, the crews remove at least one sidewalk panel in front of the house, excavate a hole by the outside meter, and bore the service line from the sidewalk to the house.

For inside meters, the crew will make a two- to three-hour appointment at a time that works with the resident. We encourage customers to work with the crew on where they want the meter to go, keeping limitations in mind such as a minimum of three feet away from areas such as windows, doors, and vents. Customers with outside meters will be notified prior to the replacement or connection of the service lines to the new mains.

The technician will access the natural gas meter inside the house, move the meter outside, and relight the natural gas appliance pilot lights after the new meter has been relocated.


Restoration

After the service line and meter work, the gas crew will backfill the excavated areas with dirt or gravel. This will be temporary before the restoration crew comes. On boulevards and lawns, they will refill the areas with black dirt, grass seed, and netting made of wood fiber that degrades over about four months. Prior to mowing the restored area, remove any loose staples that secured the netting. For photo examples, please visit our Restoration Practices page.

We hope to minimize the disruption as much as possible. Thank you in advance for your patience and understanding as we replace our infrastructure. We wish you a great season.

​​
