Minneapolis – Cedar-Isles-Dean


Anticipated timeline: approx. three weeks starting Monday, April 10


Project resources

  • If you contact CenterPoint Energy, please reference the project’s number 105234924.

 CNP Map of Minneapolis Cedar Isles Dean.png


Overview

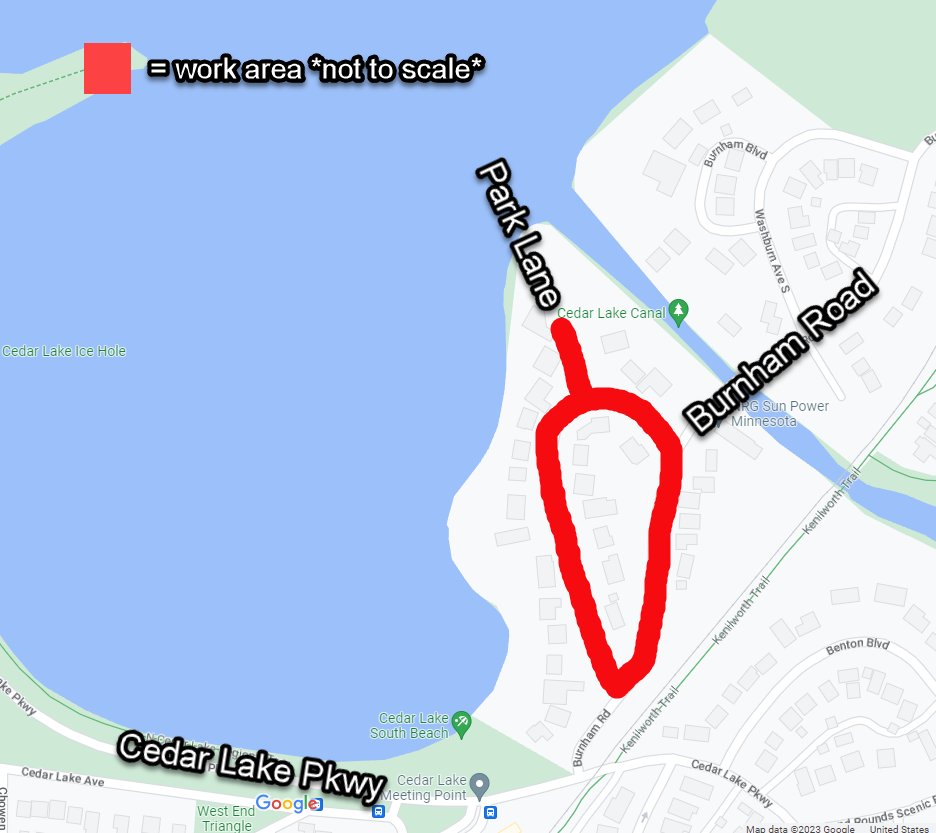

For approximately three weeks beginning on Monday, April 10, CenterPoint Energy’s authorized contractors will work in the Cedar-Isles-Dean Neighborhood in Minneapolis on Park Lane and Burnham Road at Cedar Lake Parkway.

Equix Integrity updates our records on the locations of sewer lines in relation to natural gas lines. Michels Corporation will replace a natural gas main, move inside meters to the outside of homes, and replace or reconnect service lines as needed. Q3 Contracting will restore the areas affected by Michels Corporation’s work. There will be no assessment or cost associated with our work.

The crew plans to work with the following schedule: approximately one week for replacing the main, approximately one week for working on the service lines and meters, and approximately one week for restoring the areas affected by construction.


Marking utilities

CenterPoint Energy will contact Gopher State One Call 811 to locate public underground utilities such as water, sewer, and cable. You will see markings such as spray paint and utility flags. They will be color-coordinated to indicate a separate utility.

If you have installed any private lines such as sprinklers or dog fences, we ask that you mark them with whatever material is convenient for you. Examples include spray paint, flags, and wooden sticks used to stir paint. Marking sprinkler heads is sufficient.


Small-diameter natural gas plastic main work

One crew will replace the small-diameter natural gas main. They plan to bore it underneath the boulevard. Another crew will follow to work on the service lines and meters.

Please keep in mind that some intersections may not be permanently restored until after the service line work is done. After all customers’ service lines are transferred to the new main, the crew can connect the new main to the existing intersecting mains and put the new main into service. Then the restoration crew will permanently restore these areas. Until then, customers may see temporary backfill such as dirt or gravel. We thank you for your patience!


Service line and meter work

The customer will receive a CenterPoint Energy postcard in the mail explaining the project before the natural gas crews perform the work. The crews will have CenterPoint Energy-authorized photo IDs. After the customer receives the postcard, the foreman will arrive at the customer’s house to schedule an appointment that typically meets with the customer’s schedule. If the customer isn’t home when they arrive, they will leave a door tag with their contact information to schedule an appointment with them.

One natural gas crew typically works on about one block per week. They will either fully replace the service line or reconnect it to the new main, depending on the line’s age. For most properties, the crews dig in the boulevard in front of the house, excavate a hole by the outside meter, and bore the service line from the boulevard to the house.

For inside meters, the crew will make a two- to three-hour appointment at a time that works with the resident. We encourage customers to work with the crew on where they want the meter to go, keeping limitations in mind such as a minimum of three feet away from areas such as windows, doors, and vents. Customers with outside meters will be notified prior to the replacement or connection of the service lines to the new mains.

The technician will access the natural gas meter inside the house, move the meter outside, and relight the natural gas appliance pilot lights after the new meter has been relocated.


Restoration

After the service line and meter work, the gas crew will backfill the excavated areas with dirt or gravel. This will be temporary before the restoration crew comes. On boulevards and lawns, they will refill the areas with black dirt, grass seed, and netting that degrades over about four months. Prior to mowing the restored area, remove any loose staples that secured the netting. For photo examples, please visit our Restoration Practices page.

We hope to minimize the disruption as much as possible. Thank you in advance for your patience and understanding as we replace our infrastructure. We wish you a great season.
